Forecourt Construction & Petroleum Infrastructure

Forecourt Construction and Dispenser Installation Costs for Petrol Stations in Kenya (2026 Guide)

Forecourt construction and dispenser installation costs in Kenya can range from KES 3 million for a basic setup to well over KES 15 million for a full commercial station. This guide breaks down every cost component so you know exactly what you are paying for before the first concrete is poured.

Petrol station forecourt construction and dispenser installation in Kenya by Universal Innovations

A completed forecourt project by Universal Innovations and Industrial Ltd, canopy, pump islands, paving, and drainage all built to EPRA standards.

Setting up a petrol station in Kenya is one of the most capital-intensive decisions an investor or business owner can make. The numbers being quoted vary wildly depending on who you ask, and many investors go into the process without a clear picture of what each stage actually costs. That confusion leads to underfunded projects, compliance failures, and expensive rework.

At Universal Innovations and Industrial Ltd, we have designed, built, and handed over forecourt projects across Kenya, from straightforward single-island setups to full multi-pump commercial stations. We know what these projects actually cost, what EPRA requires, and where things tend to go wrong.

This guide covers every cost component involved in forecourt construction and dispenser installation in Kenya, civil works, canopy, underground tanks, piping, dispensers, electrical, and regulatory compliance, with real 2026 figures so you can budget accurately.

Who this guide is for Investors planning a new petrol station, oil marketing company franchise operators, independent fuel retailers, and project managers overseeing petroleum infrastructure construction in Kenya.

What Does It Cost to Build a Petrol Station in Kenya?

The total cost to build a petrol station in Kenya depends heavily on the size of the station, the number of pump islands, the location, and the quality of finishes. Based on current market rates and projects delivered across Kenya, here is what investors should plan for:

Small / Rural Station

KES 5M to 10M

1 to 2 pump islands, basic canopy, 2 to 3 underground tanks, simple office structure

Standard Urban Station

KES 10M to 20M

3 to 4 pump islands, full canopy, 3 to 4 tanks, oil interceptors, proper drainage

Modern Multi-Pump Station

KES 20M to 40M

6 or more islands, large branded canopy, convenience store, car wash bay, full automation

Premium / Highway Station

KES 40M to 100M+

Full branded facility, multiple services, restaurant, LPG, automated forecourt management system

These figures cover construction and equipment only and exclude land acquisition, which can range from KES 1 million in rural areas to KES 20 million or more for prime urban locations along busy highways or at key intersections.

Important note on starting capital Beyond construction costs, you will need approximately KES 3 million in working capital for the initial fuel stock from your oil marketing company. Factor this into your total investment plan before you break ground.

EPRA Permits and Regulatory Requirements Before Construction Begins

Before a single shovel goes into the ground, you need a Petroleum Retail Station Construction Permit from the Energy and Petroleum Regulatory Authority (EPRA). EPRA does not charge a fee for this permit, but obtaining it takes approximately 45 days after a complete application is submitted.

The permit application requires drawings and documentation from registered engineers. EPRA's technical standards, referenced specifically in KS 1969:2013 and KS 2506:2014, govern how the station must be designed and built. Any contractor who cannot demonstrate familiarity with these standards should not be on your site.

Documents Required for the EPRA Construction Permit

  • Certificate of Incorporation or business registration
  • Environmental Impact Assessment (EIA) licence from NEMA
  • Proof of land ownership or a lease agreement of at least 10 years
  • Architectural drawings from a registered engineer showing site layout and forecourt design
  • Mechanical engineer's drawings specifying underground tank and piping design
  • Civil engineer's drawings showing tank cradle, backfill design, forecourt surface, and drainage layout
  • Permit to construct auxiliary entry and exit lanes from KeNHA, KURA, or KeRRA (depending on road type)
  • Permission to construct from the County Physical Planning Office
  • An Emergency Response Plan summary
  • GIS coordinates of the proposed location
  • Priced bill of quantities by a registered engineer

After construction, EPRA conducts a pre-licensing inspection before issuing the Licence for Retail of Petroleum Products. This licence requires calibration certificates for all dispensers from the Weights and Measures Department and tank testing certificates from a certified inspector.

Timeline expectation From permit application to final operating licence, allow 4 to 6 months minimum for a straightforward project. Complex sites or locations near sensitive areas may take longer. Build this timeline into your project plan from day one.

Civil Works and Forecourt Construction Costs in Kenya

The civil works component covers everything you can see at ground level: the forecourt surface, drainage, pump island bases, bollards, curbs, and the slab itself. This is where shortcuts have the most visible consequences and where poor workmanship creates long-term problems.

Petrol station forecourt civil works and paving in Kenya, pump islands and concrete surface

Forecourt civil works at a Universal Innovations project, heavy-duty concrete paving, oil interceptors, and properly graded drainage are non-negotiable for EPRA compliance.

Forecourt Paving and Surface Works

The forecourt surface must be heavy-duty concrete or reinforced paving capable of handling the weight of fuel delivery tankers, which can exceed 30 tonnes. Standard floor tiles or light-duty paving will fail within months under this load. EPRA's construction standards require properly designed hard-standing surfaces.

Civil Works ItemIndicative Cost (KES)
Heavy-duty concrete paving (per m²)2,250 to 4,500 per m²
Road curbs and edge demarcation (per m)1,800 to 4,000 per m
Bollards under canopy (per unit)9,000 to 18,000 per unit
Roadside bollards (per unit)4,000 to 9,000 per unit
Shallow drainage channels (per m)1,200 to 2,500 per m
Oil-water separator (OWS) installation80,000 to 200,000
Underground tank access manholes (each)18,000 to 35,000
Generator room (structure)90,000 to 180,000
Office and store structure180,000 to 600,000
Total civil works (standard station)1,500,000 to 4,000,000

Oil-Water Separators and Drainage

NEMA requires that all fuel stations install an oil-water separator system to prevent petroleum contamination of groundwater and soil. This is not optional. The separator intercepts runoff from the forecourt surface before it enters the stormwater system. Stations found operating without adequate OWS systems face closure and prosecution under Kenya's environmental regulations.

Petrol Station Canopy Construction Costs in Kenya

The forecourt canopy is the most visible element of your petrol station and one of the most significant individual cost items in the budget. A well-built canopy protects your staff, customers, and dispensers from rain and sun, and it carries your branding. A poorly built one corrodes within a few years and becomes a liability.

Canopy structures in Kenya are steel-fabricated, with column sizes, beam spans, and cladding specifications varying by station size. Universal Innovations and Industrial Ltd handles canopy design, fabrication, and installation as part of our complete forecourt construction service. Our industrial fabrication capability means the steel structure is engineered and built in-house, not subcontracted.

Canopy TypeApproximate SizeIndicative Cost (KES)
Small canopy (1 to 2 islands)18 x 24 ft650,000 to 1,200,000
Standard canopy (2 to 3 islands)24 x 40 ft1,200,000 to 2,200,000
Large canopy (4 islands)30 x 40 ft2,200,000 to 3,500,000
Extra-large canopy (highway station)40 x 48 ft and above3,500,000 to 6,000,000+
Canopy branding and fascia (separate)Per station70,000 to 250,000
Canopy cost does not include branding Canopy prices above cover the steel structure, columns, purlins, and cladding only. Oil marketing company branding, signage, and digital price displays are separate items. If you are building a branded station for TotalEnergies, Shell (Vivo Energy), Rubis, or National Oil, your OMC may have specific structural and branding specifications that affect cost.

Underground Storage Tank Costs and EPRA Standards

Underground fuel storage tanks are the most tightly regulated component of any petrol station in Kenya. EPRA requires that tanks be double-walled steel or fibreglass, installed in concrete-encased pits with leak detection systems. Most standard stations install at least three tanks to store petrol, diesel, and kerosene separately.

Tank capacity is measured in litres, and the most common size for commercial stations is 20,000 litres per tank. Smaller independent stations may use 10,000-litre tanks to reduce upfront cost. Larger highway stations or those with high throughput install 30,000-litre or larger tanks.

Tank CapacityIndicative Cost per Tank (KES)
5,000 litres130,000 to 250,000
8,000 litres180,000 to 320,000
10,000 litres250,000 to 450,000
15,000 litres300,000 to 580,000
20,000 litres (EPRA standard)450,000 to 900,000
30,000 litres700,000 to 1,400,000

Tank installation includes excavation, concrete cradle and backfill design, access manholes, vent pipes, leak detection sensors, and pressure testing. Add approximately KES 80,000 to 200,000 per tank for installation works beyond the tank supply price itself.

After construction: tank testing is mandatory Before EPRA will issue your operating licence, every storage tank must have a valid calibration certificate and a pressure test report from a certified inspector. Budget time and cost for this in your post-construction schedule. Calibration is charged per litre of tank capacity.

Piping and Fuel Line Installation Costs

Piping connects your underground tanks to the dispensers on the forecourt. In Kenya, single-wall piping is the minimum standard for basic setups, but double-wall piping is increasingly specified for new builds because it provides secondary containment if the primary pipe leaks.

EPRA and NEMA both focus heavily on piping integrity during their inspections. Poorly installed pipes that leak fuel into the ground create environmental liability that can far exceed the cost of doing the job properly in the first place.

Piping ItemIndicative Cost (KES)
Single-wall piping (per line)20,000 to 45,000 per line
Double-wall piping (per line)45,000 to 90,000 per line
Submersible pump per tank35,000 to 80,000
Vapour recovery system120,000 to 280,000
Pressure testing (per line)5,000 to 15,000
Total piping works (standard 3-tank station)200,000 to 500,000

Note that EPRA's 2025 regulations now specifically require vapour recovery systems on storage tanks to control fuel vapour emissions. This was previously common only at larger stations but is now a standard compliance requirement for new builds.

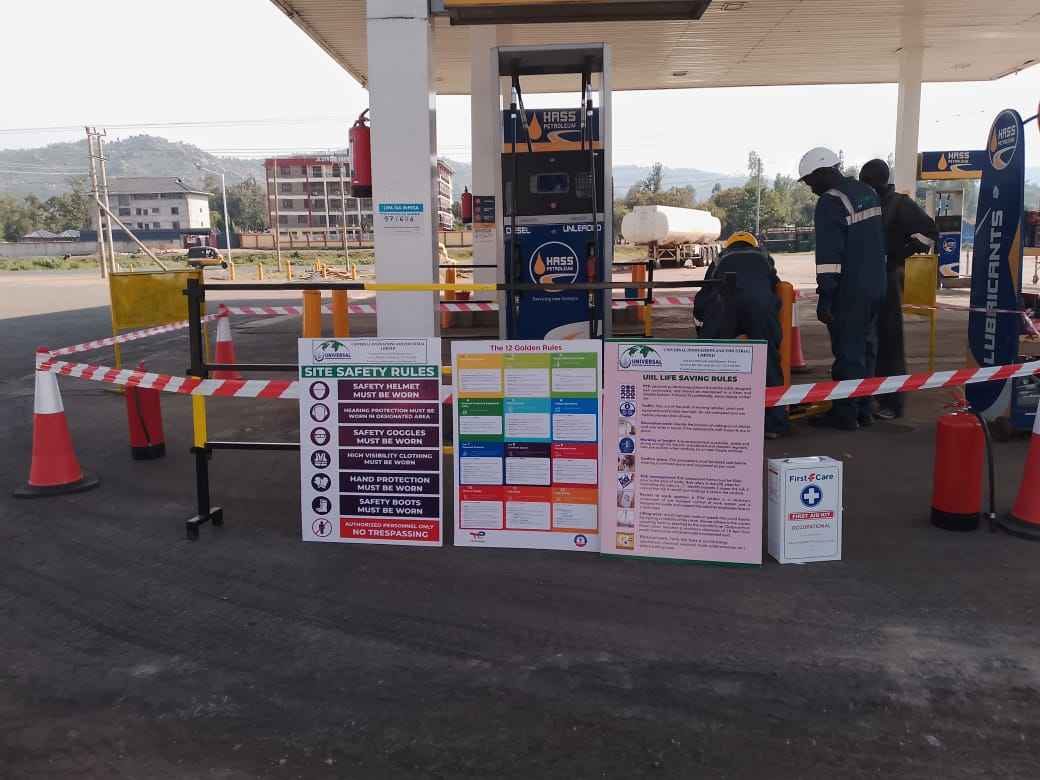

Fuel Dispenser Installation Costs in Kenya

The fuel dispenser is what your customers see and interact with every single day. Choosing the wrong specification, buying uncertified units, or skipping calibration will cost you far more than the saving you think you are making. Dispensers in Kenya must be calibrated and certified by the Kenya Bureau of Standards (KEBS) Weights and Measures Department before the station opens.

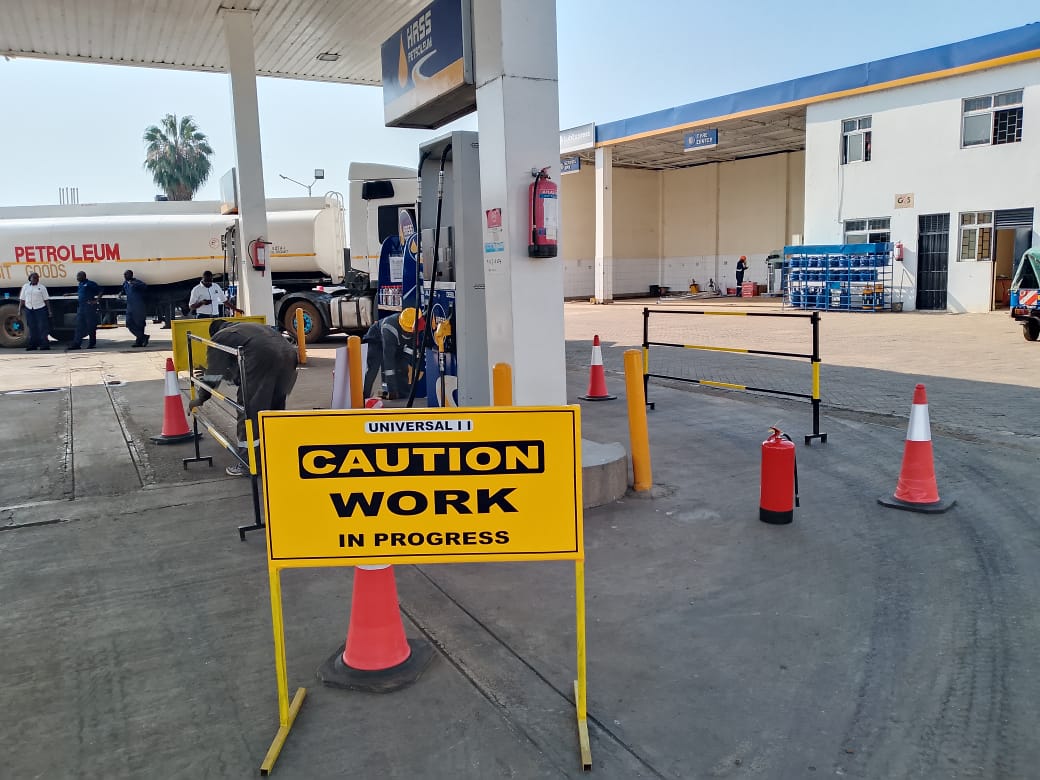

Fuel dispenser installation at a petrol station forecourt in Kenya

Fuel dispenser installation requires proper pump island bases, piping connections, electrical wiring, and KEBS calibration before the station can legally operate.

Types of Dispensers and Costs

Dispensers vary by number of nozzles, number of products dispensed, flow rate, and technology level. A single-nozzle unit dispenses one product through one hose. A multi-product dispenser can deliver petrol and diesel from a single unit with separate nozzles.

Dispenser TypeSupply Cost (KES)Installation (per unit)
Single-nozzle, single-product (entry level)82,000 to 180,0008,000 to 15,000
Dual-nozzle, single-product (standard)250,000 to 400,00010,000 to 20,000
Multi-product digital dispenser400,000 to 650,00015,000 to 30,000
High-capacity with touchscreen and POS650,000 to 800,000+20,000 to 40,000
KEBS calibration certificate (per nozzle)2,000 per nozzleIncluded in calibration

For a standard 3-island station with 6 dispensers, budget between KES 1.5 million and KES 3 million for dispenser supply and installation combined, depending on the specification level.

What to specify when buying dispensers in Kenya Ensure any dispenser you purchase meets KEBS accuracy requirements, has emergency cut-off systems and automatic shutoff nozzles, is built from corrosion-resistant materials suited to Kenya's climate, and supports electronic transaction recording if you plan to run a forecourt management system. Only buy from suppliers who offer installation, calibration, and after-sales maintenance.

Electrical Systems, Lighting, and Fire Safety Costs

Electrical work at a petrol station is not standard building wiring. All electrical systems in and around a fuel station forecourt must be explosion-proof rated because of the risk of ignition from fuel vapour. This is a specialist area where using a general electrician without petroleum facility experience creates serious safety and compliance risks.

Universal Innovations and Industrial Ltd handles electrical installations for petroleum facilities in-house, including explosion-proof wiring, canopy LED lighting, earthing and bonding systems, and generator integration.

Electrical and Safety ItemIndicative Cost (KES)
Explosion-proof electrical wiring (forecourt)200,000 to 500,000
Canopy LED lighting installation80,000 to 200,000
Security lighting and CCTV60,000 to 180,000
Earthing and bonding systems30,000 to 80,000
Generator (9KVA backup, supply and install)250,000 to 450,000
Fire extinguishers, sand buckets, and signage22,000 to 60,000
Fire suppression system (larger stations)200,000 to 600,000
Total electrical and fire safety500,000 to 1,500,000

Ancillary Structures, Branding, and Station Management Systems

Beyond the core forecourt infrastructure, a complete petrol station requires several additional items that are easy to underestimate in the initial budget.

ItemIndicative Cost (KES)
Office and store building180,000 to 600,000
Forecourt management system (tanks + dispensers)350,000 to 650,000
Dip stick and manual level gauges5,000 to 15,000
Signboards and price totems (per sign)16,000 to 45,000
Canopy branding (OMC specification)70,000 to 250,000
Water storage tank (5,000L)40,000 to 70,000
Perimeter fencing or wall200,000 to 800,000
Staff uniforms and operational equipment20,000 to 50,000
Forecourt management systems are worth the investment A complete forecourt management system monitors tank levels, tracks dispenser throughput, and generates sales reports in real time. For a busy station, this system pays for itself quickly by eliminating manual dipping errors and fuel theft. Budget KES 350,000 to 650,000 for a full system covering tanks, dispensers, and back-office reporting.

Complete Forecourt Construction Cost Breakdown (Standard Station)

The table below consolidates all cost components for a standard urban petrol station in Kenya: 3 pump islands, 6 dispensers, 3 underground tanks at 20,000 litres each, a standard-sized canopy, and full EPRA-compliant civil works. This is the most common station size for commercial development in Nairobi, Mombasa, Kisumu, Nakuru, and Eldoret.

Cost ComponentLow Estimate (KES)High Estimate (KES)
Civil works and forecourt paving1,500,0004,000,000
Canopy structure and cladding1,200,0002,200,000
Underground storage tanks (3 x 20,000L)1,350,0002,700,000
Tank installation (excavation, cradle, manhole)300,000600,000
Piping and fuel lines200,000500,000
Fuel dispensers (6 units, dual-nozzle)1,500,0003,000,000
Electrical systems and fire safety500,0001,500,000
Office, generator room, ancillary structures300,000800,000
Forecourt management system350,000650,000
Branding and signage150,000350,000
Regulatory compliance and inspections50,000150,000
Total Construction Cost7,400,00016,450,000

Figures exclude land acquisition, NEMA EIA costs, road authority permits, initial fuel stock, and staff salaries. All rates are indicative 2026 market figures for Nairobi and surrounding areas. Coastal and remote sites may vary by 10 to 20%.

Common Mistakes That End Up Costing Petrol Station Investors More

  • 💸
    Choosing a contractor on price alone

    The cheapest quote for a petrol station build almost always cuts corners on tank installation, piping quality, or civil works specification. When EPRA's inspection team arrives and finds non-compliant work, you will pay twice, once to do it wrong and once to do it right. Verify that any contractor you engage has completed petroleum facility projects and can show you completed stations.

  • 📐
    Starting construction without EPRA approval

    Some investors begin civil works before the EPRA construction permit is in hand to save time. This is illegal and can result in a demolition order for all works done without approval. The 45-day review period is fixed. Use that time to finalise your contractor selection and procurement.

  • 🔩
    Buying uncalibrated or non-KEBS-compliant dispensers

    Dispensers sold without KEBS calibration cannot be used commercially. EPRA will not issue your operating licence until every nozzle has a valid calibration certificate from the Weights and Measures Department. Buying cheap uncertified units and then having them rejected adds weeks of delay and replacement cost.

  • 🌊
    Underinvesting in drainage and oil-water separation

    NEMA audits petroleum facilities regularly. A station without a properly designed oil interceptor system faces closure and prosecution regardless of how long it has been operating. This is a mandatory infrastructure item, not an upgrade.

  • ⚠️
    Not budgeting for working capital alongside construction

    Many investors spend their entire budget on construction and have nothing left for the initial fuel stock required to open. Your oil marketing company will require payment for the first stock delivery before they will release fuel. Budget at least KES 3 million for this separately from your construction costs.

Why Petrol Station Investors Work With Universal Innovations and Industrial Ltd

Universal Innovations and Industrial Ltd is a full-service mechanical and construction company with over two decades of experience delivering petroleum infrastructure, civil works, industrial construction, and mechanical engineering across Kenya and Uganda. We are not a general contractor who occasionally takes a petrol station job. Petroleum forecourt construction is a core part of what we do.

  • 1
    Complete Forecourt Delivery Under One Roof

    We handle civil works, canopy fabrication and installation, underground tank installation, piping, electrical systems, and dispenser commissioning. You deal with one contractor, one programme, and one point of accountability, not five separate subcontractors who blame each other when things go wrong.

  • 2
    EPRA-Compliant Engineering and Documentation

    Our engineering team produces all required EPRA drawings in-house, site layout, underground tank designs, forecourt drainage, and piping schematics. Every drawing is done by registered engineers and references KS 1969:2013 and KS 2506:2014 as required. Your permit application goes in complete, the first time.

  • 3
    Proven Track Record Across Kenya

    We have delivered forecourt projects for clients across Nairobi, Mombasa, and multiple counties. Ask us for project references and go visit completed stations before you sign anything. Our work at sites like HASS Nyali Phase 1 and Nyali Phase 2 demonstrates the level of execution we bring to petroleum facilities.

  • 4
    ERP-Based Project Tracking

    We manage every project through ERPNext, giving you real-time visibility on construction progress, material procurement, and milestone completion. You always know where your project stands without having to chase updates.

  • 5
    Post-Completion Support

    Our relationship does not end at handover. We provide maintenance services, equipment servicing, and structural repairs for operating stations. When your forecourt needs attention six months after opening, we are reachable.

Planning a Petrol Station in Kenya? Talk to Our Forecourt Team

Universal Innovations and Industrial Ltd delivers complete forecourt construction and dispenser installation across Kenya. From EPRA permit drawings through to station handover, we manage the entire project so you can focus on your investment. Get a detailed cost estimate for your specific site and station size.

Frequently Asked Questions About Petrol Station Construction Costs in Kenya

How much does it cost to build a petrol station in Kenya in 2026?
A standard urban petrol station with 3 pump islands, 6 dispensers, and 3 underground tanks of 20,000 litres each costs between KES 7.4 million and KES 16.5 million for construction and equipment. A smaller rural station can be done for KES 5 million to KES 10 million. A modern multi-pump highway station with a convenience store and car wash can reach KES 40 million or more. Land is separate and varies from KES 1 million in rural areas to KES 20 million or more for prime urban sites.
What is the cost of a fuel dispenser in Kenya?
A single-nozzle entry-level dispenser starts from around KES 82,000. A standard dual-nozzle unit costs KES 250,000 to 400,000. A digital multi-product dispenser with POS integration costs KES 400,000 to 650,000. High-capacity units with touchscreen displays can reach KES 800,000 and above. Installation adds KES 8,000 to 40,000 per unit depending on the complexity of the piping connection. KEBS calibration is charged at KES 2,000 per nozzle.
How much does an underground storage tank cost in Kenya?
A 20,000-litre underground storage tank conforming to EPRA standards costs KES 450,000 to KES 900,000 per tank in supply. Installation works including excavation, concrete cradle, backfill, access manholes, and vent pipes add KES 80,000 to 200,000 per tank. Most standard stations install three tanks, so budget KES 1.6 million to 3.3 million for the complete underground tank system.
What permits do you need to build a petrol station in Kenya?
You need a Petroleum Retail Station Construction Permit from EPRA, which requires architectural and engineering drawings by registered engineers, an EIA licence from NEMA, county government planning approval, and road authority permits from KeNHA, KURA, or KeRRA depending on the road classification. EPRA does not charge for the construction permit, and the review takes approximately 45 days. After construction, you need a Licence for Retail of Petroleum Products, which requires an EPRA inspection and calibration certificates for all dispensers from KEBS.
How long does it take to build a petrol station in Kenya?
From permit application to opening day, allow 6 to 12 months for a straightforward station. The EPRA construction permit alone takes 45 days to process. Actual construction time for a standard station is 3 to 5 months once permits are in place. Post-construction EPRA inspection and licence issuance takes 30 days. Complex sites, imported equipment delays, or non-compliant first inspections can extend this significantly.
Does Universal Innovations build petrol stations in Kenya?
Yes. Universal Innovations and Industrial Ltd delivers complete petrol station construction across Kenya, covering civil works, canopy fabrication and installation, underground tank installation, piping, electrical systems, and dispenser commissioning. We have delivered forecourt projects across multiple counties and work with both independent fuel retailers and oil marketing company franchise operators. Contact us through our website for a project consultation and cost estimate.
What is the EPRA construction permit for a petrol station?
The EPRA Petroleum Retail Station Construction Permit is the authorisation required before any construction work begins on a new fuel station in Kenya. It is issued by the Energy and Petroleum Regulatory Authority under the Energy Act, 2019 and the Petroleum (Retail Dispensing Site Construction and Licensing) Regulations, 2025. The permit is free of charge and takes approximately 45 days to process after a complete application with all required engineering drawings and supporting documents is submitted.
